In the ISMS Assistant you open the Objectives & Planning chapter to turn the control decisions from the Statement of Applicability into a risk treatment plan, define measurable information security objectives, and then work through the execution criteria of each planned control in the Implementation chapter. On the first page you set an implementation status with a responsible lead and target date for every applicable control, on the second you define objectives at programme, risk and control level, and in the following chapter you break the planned controls down into assignable tasks.
Build the risk treatment plan
Open the Objectives & Planning chapter

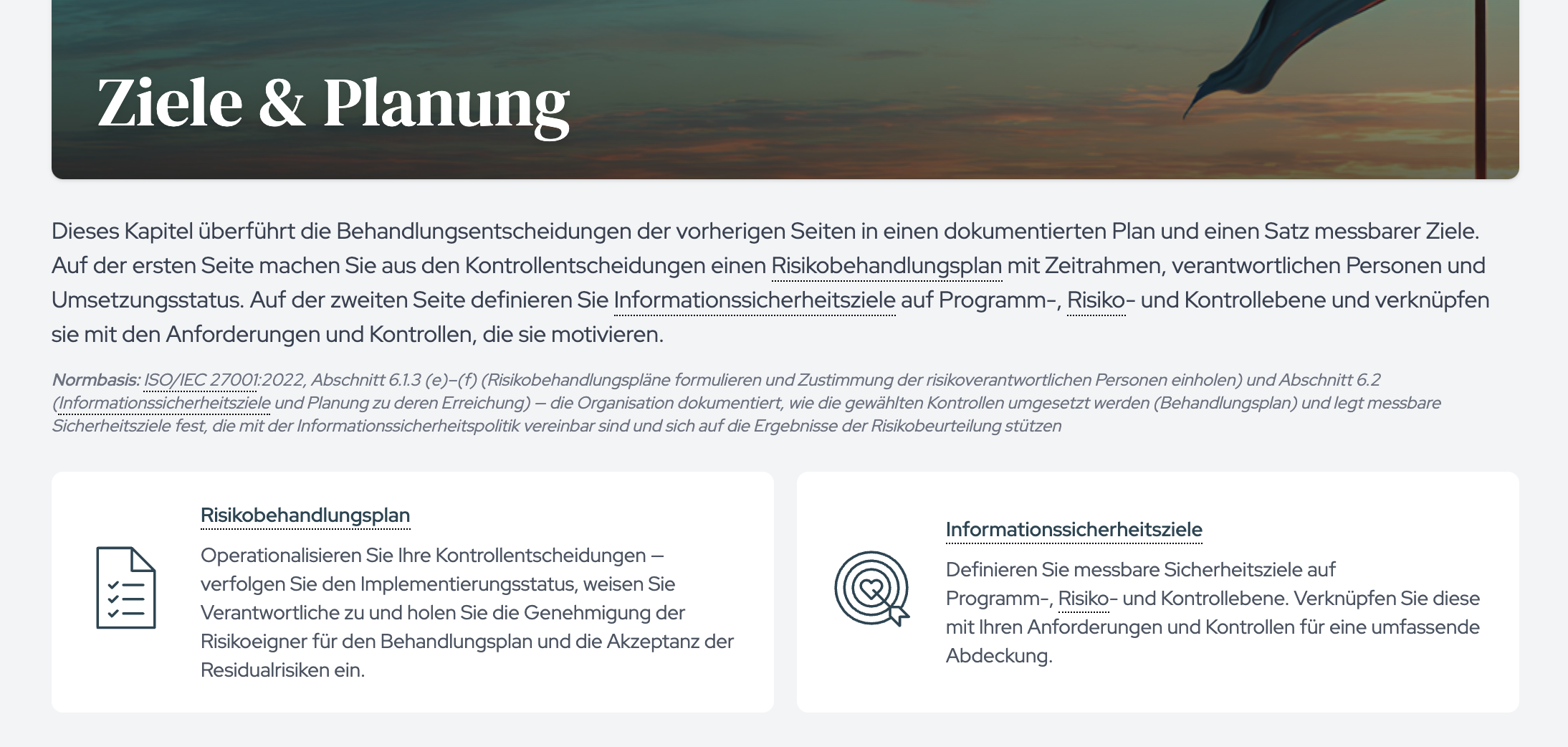

Open the ISMS Assistant and switch to the Objectives & Planning chapter. The intro page shows two topic cards: Risk Treatment Plan and Information Security Objectives. Start with the treatment plan.
Set an implementation status per control

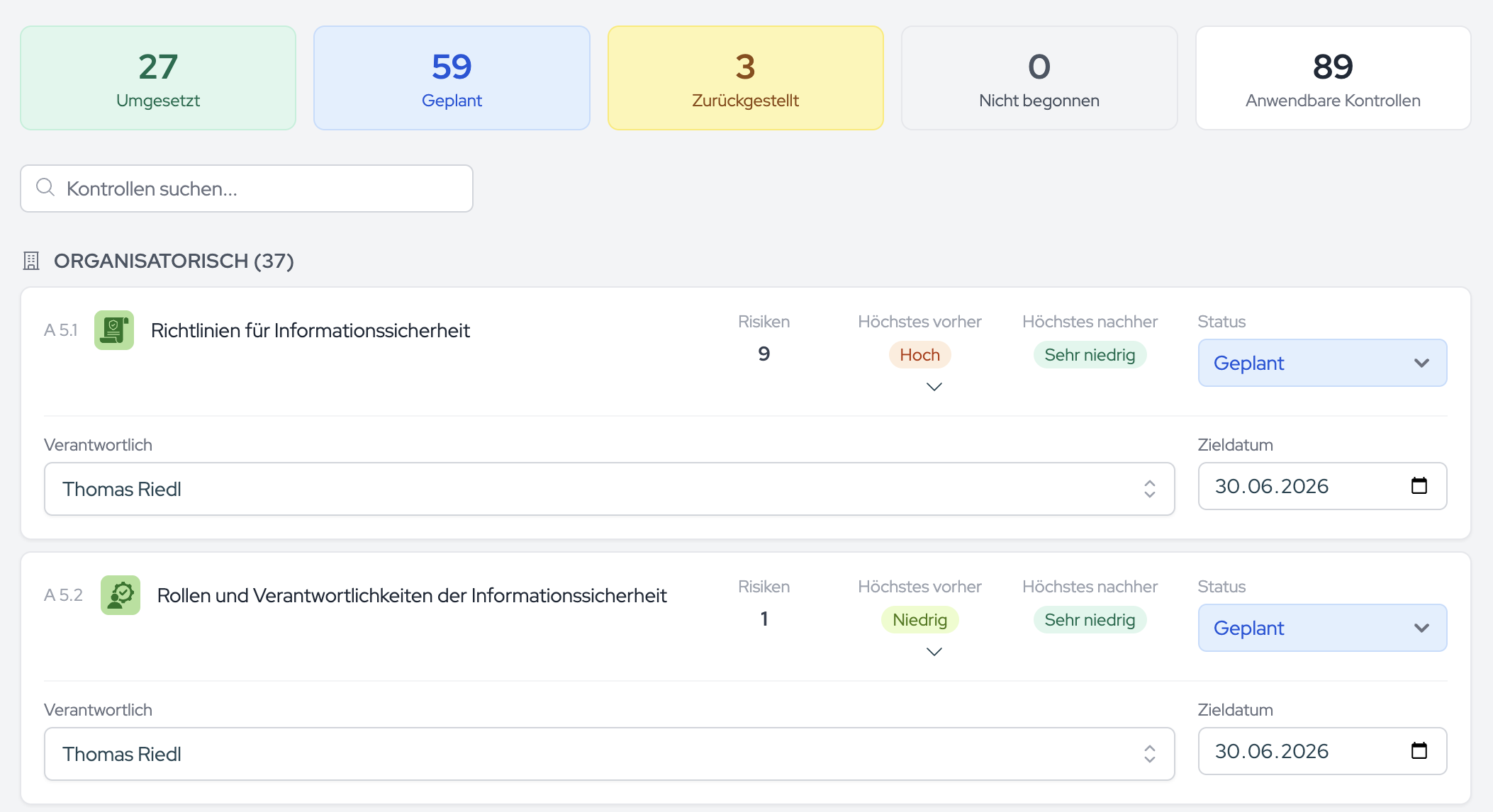

The Risk Treatment Plan page lists every applicable control from the Statement of Applicability, grouped by theme: organisational, people, physical and technological. In the Status field, set one of four values per control: Implemented, Planned, Deferred or Not started. Start with the already-operational controls and set them to Implemented so the summary cards at the top show a realistic baseline.
Add leads, dates and justifications
Selecting Planned reveals the Lead and Target date fields. Fill in both immediately so a planned control stays clearly distinguishable from a deferred one. Selecting Deferred reveals a justification field; enter the reason there, such as a pending budget approval or a dependency on another project. Clicking a control’s risk-context row expands the assigned scenarios with their before/after risk levels, which helps you judge urgency.
Capture risk owner approval
In the Risk Owner Approval section, record that the risk owners have approved the treatment plan and accepted the remaining risks via Accept all residual risks. ISO 27001 explicitly requires this approval (Clause 6.1.3 f). Save with Save & Continue.
Result: every applicable control carries an implementation status, planned controls have a responsible lead and target date, deferred ones have a justification, and the risk owner approval is documented.
Define security objectives
Create objectives at three levels

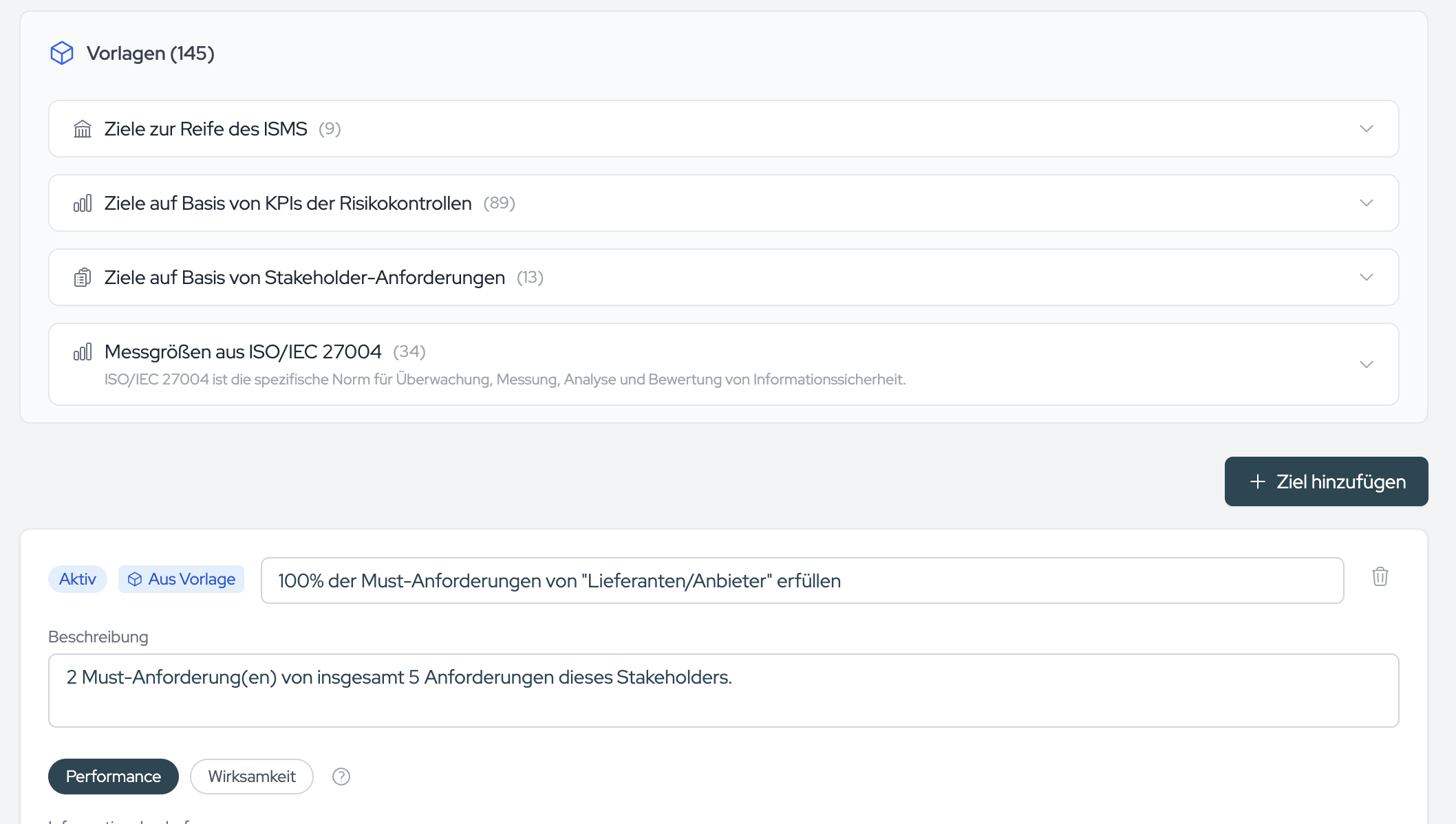

The Information Security Objectives page is split into three tabs: Program Objectives (strategic ISMS maturity), Risk-Level Objectives (effectiveness of the risk treatment), and Control-Level Objectives (operational, tied to individual controls). Cenedril suggests objectives for each tab, grouped into five template sets: ISMS maturity, control KPIs, protection needs of key assets, stakeholder requirements, and the measures of ISO/IEC 27004. Adopt the templates that fit or create your own via Add objective.
Make every objective measurable
For each objective, record what will be done, who is responsible, the target date and how the results are evaluated. Under Measurement type, choose between Binary (yes/no), KPI (measurable target) and Periodic review. For a KPI, add the target value and unit plus the traffic-light thresholds for green and yellow; the bar below the fields shows the zones visually.
Save the objectives and move on to Implementation
Use Save as Draft to keep interim states and Save & Continue to complete the Objectives & Planning chapter. The assistant then leads into the Implementation chapter.
Result: the ISMS becomes measurable. Each objective records what will be done, who is responsible, by when, which data source feeds the measurement, and where the traffic-light thresholds sit.
Implement the controls
Break planned controls into work packages
In the Implementation chapter, open the Execution Criteria Planning page. It shows every control marked Planned in the treatment plan, grouped by theme. Each control expands into groups of execution criteria from ISO 27002, where each group is a logical work package. Start with the controls whose target date is nearest; it appears in the header of each control card.
Tick off criteria and create tasks

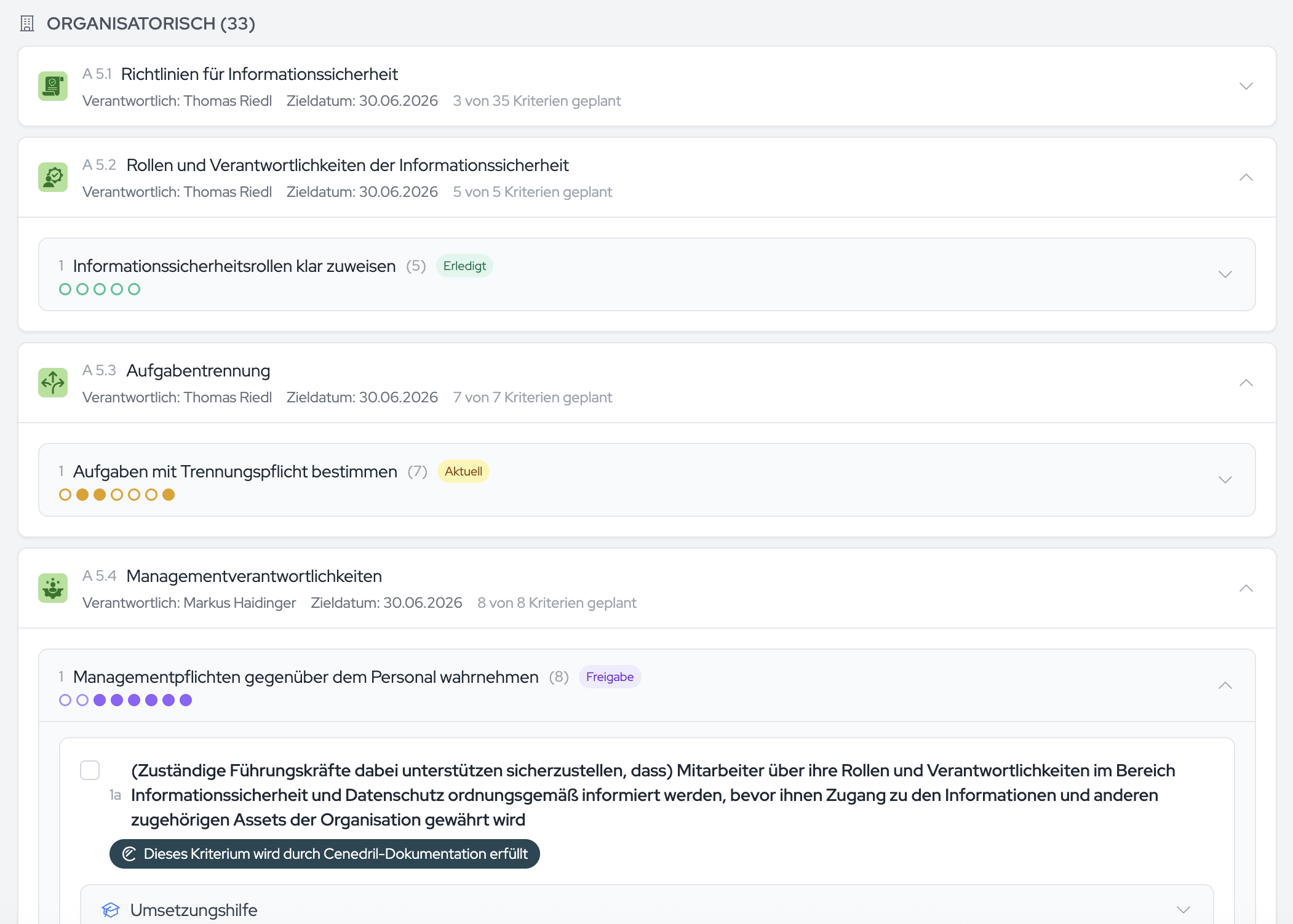

Tick off the individual criteria of a group as you work through them, and use Create task for this group to create one task per work package in the Cenedril task system. The small chevron next to a criterion expands its implementation details: how-to, subtasks, RACI and estimated effort. A Cenedril badge on a criterion indicates that it is implemented through an existing platform artefact, such as a policy, a register or the management review. Check the linked artefact before creating a new task.
Result: every planned control is broken down into work packages, the criteria are ticked off, and the tasks for the operational work sit in the system. The next chapter, Performance Evaluation, measures whether the implementation achieves the objectives you set.
